SEHSR (Southeast High Speed Rail) and the S-Line Corridor

As a former resident of Atlanta and an advocate for passenger trains there, I can tell you that the combination of indifference outside the Atlanta metro area, the highway lobby, and the influence of Hartsfield-Jackson Airport and Delta Air Lines has effectively blocked any development of passenger rail. From time to time there is still talk of Atlanta-Savannah but I’ll believe it when I see it. (I remember a demonstration train by Amtrak that ran Atlanta-Savannah in 1980.) Atlanta, Fulton County, and GDOT can’t even come up with a replacement for the embarrassingly inadequate station in Atlanta. First it was going to be downtown, then at Atlantic Center, then at the former GM BAP plant in Doraville, and now who knows. If you think Charlotte is bad, go to Peachtree Station in Atlanta.

9 Likes

Ride by Peachtree St on 85 often. I went once, the location was awful.

1 Like

NCDOT is continuing S-Line grade separations - the New Hope Church project was started this month. The road embankments are complete for Durant Road and the actual bridge will start construction in the summer. I’ve also seen the flags/spray paint for the utility work by Rogers Road.

It feels like the press release is trying to indicate that the $1B federal grant isn’t getting clawed back, but I haven’t heard anything relating to that since after Helene.

9 Likes

Based on what I’ve heard from the inside is that the state is confident that the $1B in funding will not be rescinded. The rail division is also in the process of applying for an additional grant for the S-Line, which is the $1.5B that was rescinded from the LA High-Speed Rail project. Sadly, they plan to use roughly half of Wake Transit planning funds (for next 10 years, $125M) for the 20% match (80% federal, 20% local match needed).

7 Likes

If I’m reading between the lines correctly, NCDOT’s grade separation projects (Durant, New Hope Church, Millbrook, Rogers) are the state’s “match” for the S-line project. These projects are not justifiable based on today’s rail traffic, at least compared with some other much higher traffic crossings on the NCRR, and yet they were placed in the STIP and prioritized.

This also allows them to maintain some forward progress on this project in spite of the FRA S-line grant not being disbursed yet.

As far as the local funding is concerned - Wake Transit has $164m of revenue budgeted for FY2027, $84m of which is allocated to capital expenses. From that, $24m is earmarked for regional rail. If it’s half of something - I don’t know what it’s half of. At the same time, they plan to continue that expenditure, so over 10 years it will add up to quite a bit more than $125 million.

This is what they’ve been talking about for the past year or two - spending Wake Transit money on railroad improvements to incrementally work our way to regional rail service on the NCRR and S-line. While the NCRR to Durham is probably more important from a regional transportation perspective than the S-line, Durham is hesitant to partner on any sort of rail project, while the S-line lies largely inside Wake County - so it might get prioritized.

Not to mention that there was already a separate federal CRISI grant to double track the NCRR from Cary to the new RTC location, which is about one mile past the Durham County line. I could potentially see Durham allocating a token amount toward rail platforms at the new RTC, and I could also see Wake footing the bill even if Durham refuses to participate at all.

8 Likes

All of the funding that you’ve mentioned is true and is consistent with what’s mentioned in the recently adopted Wale Transit Plan. However, NC Rail’s request for $125M to put towards a 20% local match was made a month or so after the adoption of the plan. I’ll look into it but that’s what was presented by the NC Rail division in December.

Could be that they are asking that half of what’s earmarked for regional rail go towards the S-line effort, which seems like it is reasonable and may indeed even be what that money was added to the budget for.

Perhaps the only word I disagree with in what yoh saod earlier is “unfortunately”. I think it’s good to spend a modest fraction of our transit funds on regional rail on the S line.

1 Like

Noticed this article today: https://www.newsobserver.com/news/politics-government/article314839857.html

Seems like the folks at NCDOT have done a fine job of keeping the administration placated, and it’s great news that it looks like they’ll finally unlock the $1.1B. However, it’s also completely ridiculous that this money was already allocated and approved and a new admin comes in and tries to conditionally disburse it. Probably illegal, too, but what can ya do.

3 Likes

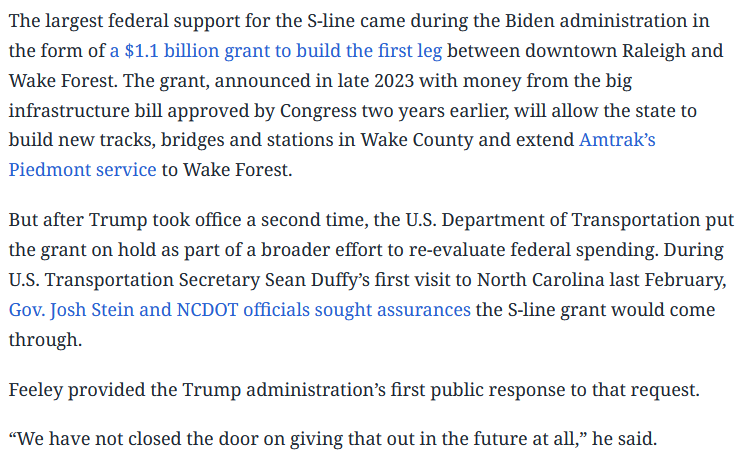

Just a point of clarification - the $1.1B has not yet been unlocked and it isn’t clear if or when it will be. What was released was a $58m CRISI grant that was awarded in 2022. Here is the section of the article discussing the larger grant.

5 Likes

Anyone have a TBJ subscription that can share if there’s anything new/substantial in this article? https://www.bizjournals.com/triangle/news/2026/05/13/trains-from-raleigh-to-wake-forest.html

1 Like

The big news is that USDOT money started flowing in early 2026. That validates NCDOT’s decision to front-load its contribution to start construction at key grade separations in North Raleigh + Wake Forest, so a 2030 completion is still achievable. Otherwise, the article is mostly a construction update.

This 2024 PPT has a list of sub-projects (pg 19) and a timeline (pg 21). The grade separations are mostly from the Beltline north to downtown WF, plus two in east Cary – including the site of a crash this month. As far as the service plan, it seems that it’ll initially function as a Piedmont extension.

The other 2026 news is that USDOT also authorized funds for the engineering on the full Raleigh-to-Richmond segment.

22 Likes

That’s great! Thanks

16 Likes

It is good to read about continuing progress on this. It is a great project, with a ton of benefits, including shortening the route, increasing safety, and improving the track. Glad to hear that more federal money is being allocated for it. That being said, I think it will be a long, long time before this actually impacts anyone going between Raleigh and Richmond.

1 Like

I’ll be happy to see a real commuter rail option for those who live in Wake Forest and work & play in Downtown Raleigh. We’ve heard the stories about folks in Cary who were able to come to the parade via the train (I even met two of them at the parade), and now the folks in Wake Forest will have the same & fast option.

14 Likes

Phase 1 of the Durant Road project is anticipated to be complete by October, and the S-Line will open by the end of 2027.

To me, the “S-Line” project means rail between Raleigh and Richmond so having it completed before end of 2027 seems incorrect. Can anyone clarify? What exactly is done before end of 2027 and does that mean any new service? I was under the impression just infra upgrades are taking place that kind of sets the stage for Raleigh to Wake Forest only. Also, don’t we need a new platform at Union Station to support a Wake Forest run?

2 Likes

Maybe 2027 is when they plan to finish construction on the infrastructure upgrades? I dont even know if the station in Wake Forest has entered the design phase yet, and there sure isn’t any construction acivity around where the station is supposed to go last I saw. The most recent opening year I saw anywhere for WF-RUS runs was 2031 so I doubt it’s that :man_shrugging:

3 Likes

I was curious about that as well. I haven’t really been following this project because it seemed so far until completion, so I also assume that’s not correct.

2 Likes

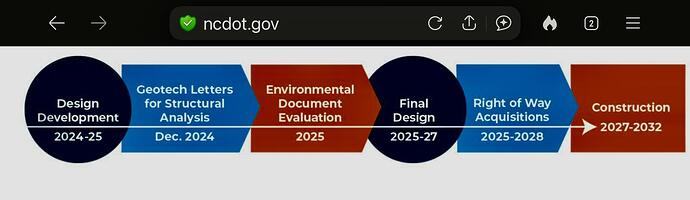

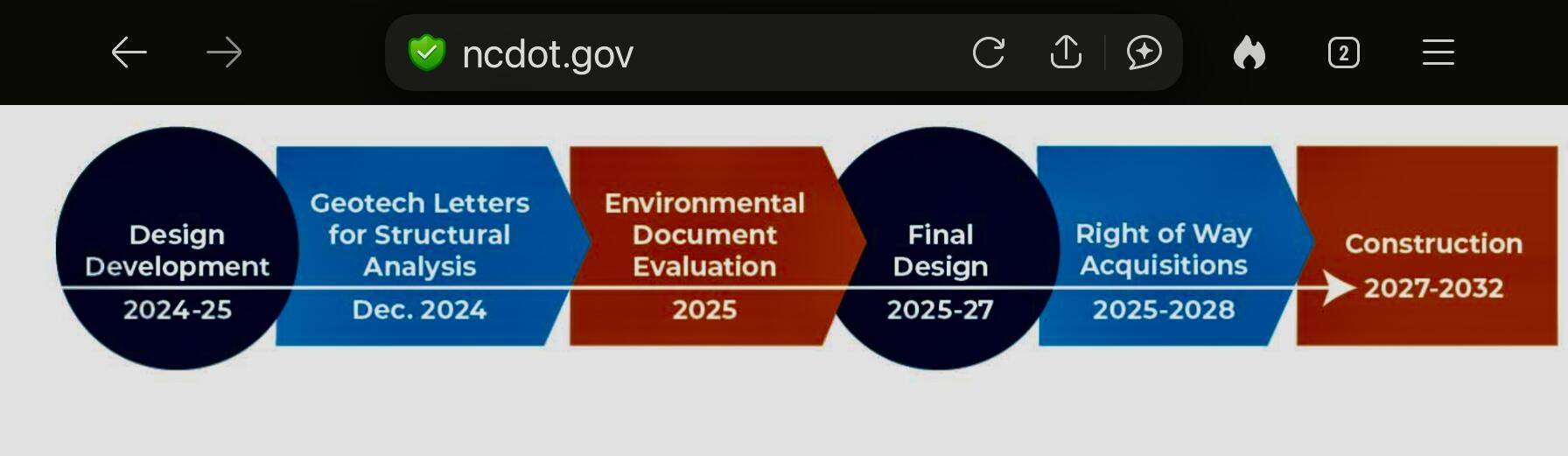

Schedule graphic from the document linked above:

5 Likes

This is a poorly written word salad of an article.

The S-Line was funded under the Biden admin to the tune of a bit over $1b. This project would have rebuilt the S-line from downtown to Wake Forest and extending Piedmont service there. However, one of the first things the Trump admin did when taking office was to throw the brakes on all passenger rail grant projects that had been awarded but not yet disbursed.

Several projects, like California HSR, had their federal funds rescinded entirely, but the Trump admin has been dropping signals all along that they are still on board with NC’s S-line project to some extent. So far they have released some money to continue design and engineering work. However, they have yet to commit to releasing the full $1+b from the grant.

The news here appears to be $65 million committed towards NC’s outright purchase of the S line. Although I can’t find any corroborating sources, and this article is such a hot mess that it makes me inclined to doubt everything it says.

The only thing likely to “open” by 2027 is the grade separation at Durant Road. There will be no passenger service to Richmond nor Wake Forest as a result of this.

The New Hope Church grade separation is probably going to finish around 2029. Millbrook Road hasn’t even broken ground yet, and it will probably take about 3 years to build. Any other projects to rebuild the corridor would be behind even that.

10 Likes
