Nice try FAA. Not today! ![]()
Tucker Street in front of the parking deck.
I was testing you without any intention of testing you. ![]()
You can tell I havenāt flown much lately otherwise I would have considered a non-answer as I would have said the same. ![]()
Quick question on the parking deck for this one. From what I can tell, it doesnāt look like thereās a garage directly under the residential tower. With that many units, do we think the resi tower is using the full garage under the office portion, or is a separate/smaller garage planned? Curious how theyāre splitting parking between the two.
@jkirk90 My understanding is that the highlighted section will be the portion of the deck that will be built for Phase 1.
Got it, thanks for sharing. With 306 units in the resi tower, that Phase 1 portion still feels pretty tight. Makes me wonder if the garage ends up being tall and skinny behind the tower, or if additional parking comes online later. Curious to see how they ultimately handle it.
This is a perfect example of not being assured parking in market rate housing downtown. Iām guessing that a parking space here will be a la carte?
Itās almost done!
![]()
Iām still just in shock that this project is moving forward.
What a skyline shift it will be! In many places downtown youāll be able to point to this building and say āthatās Glenwood Southā
Iāll definitely bring more development and high rise towers.
This development, along with The Weld/Row, and Platform are providing massive momentum for downtown Raleigh. They are acting as catalysts in what is clearly a transformative era for the city. From a fundamental standpoint, Raleigh has for some time now possessed the essential āpillars of successā solid education programs, government presence, and a notable healthcare sector. Itās encouraging to see institutional capital validating these fundamentals and putting significant belief into action.
I think it a mix of luck, convergence of technology, long term impacts of COVID, temperate climate (as we hit below freezing temps), and ānegativeā external activities in other regions of the US + other factors of course!

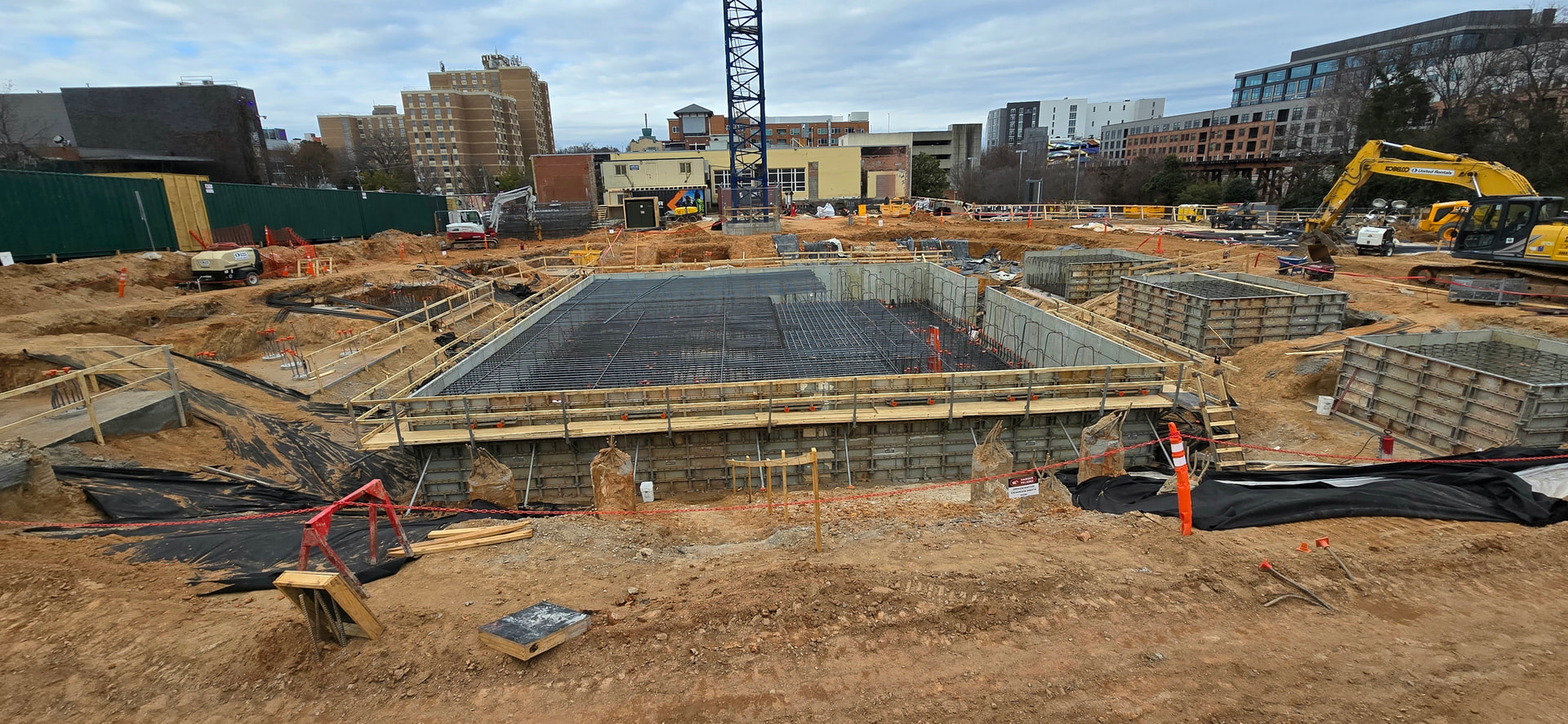

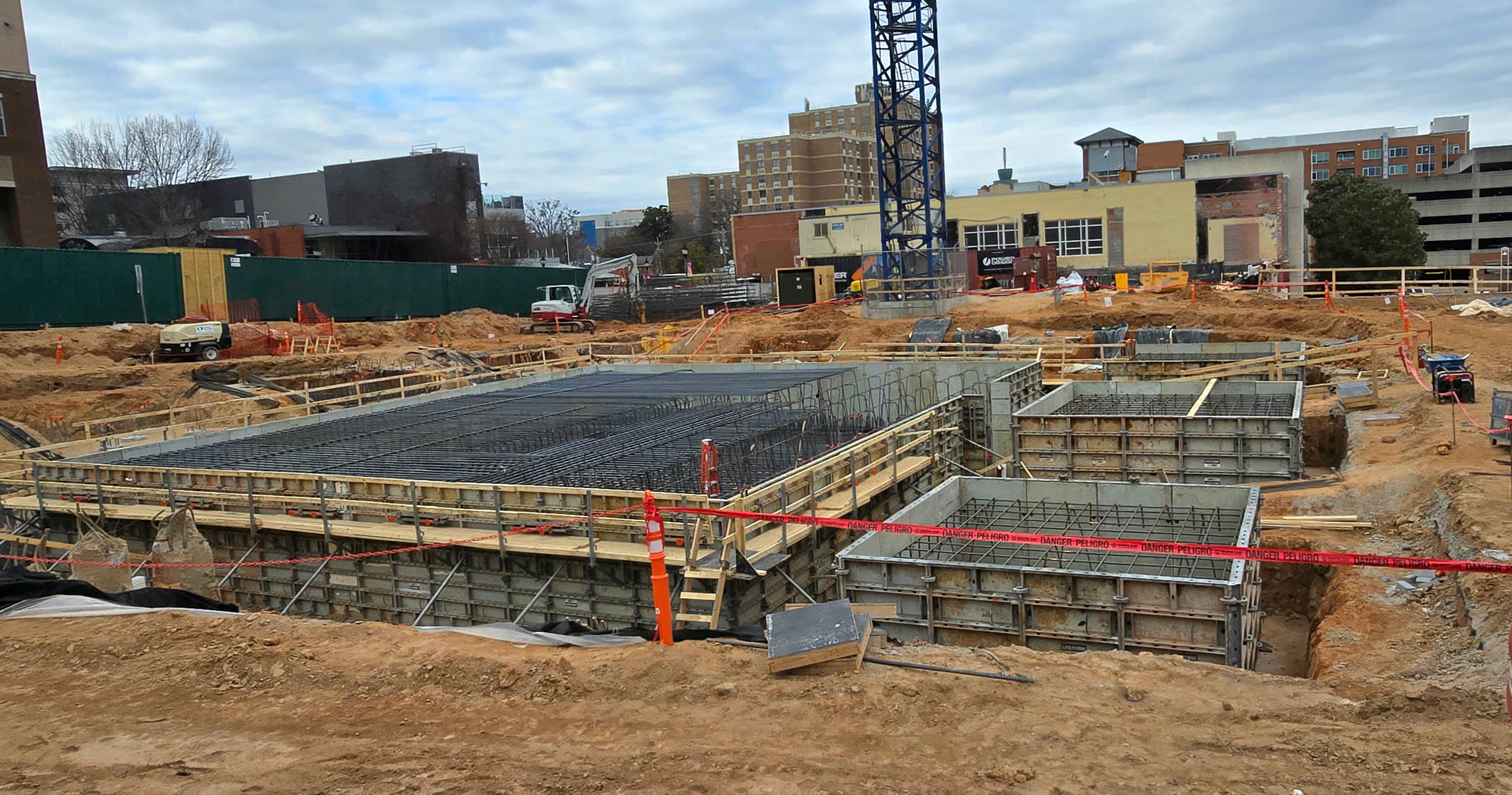

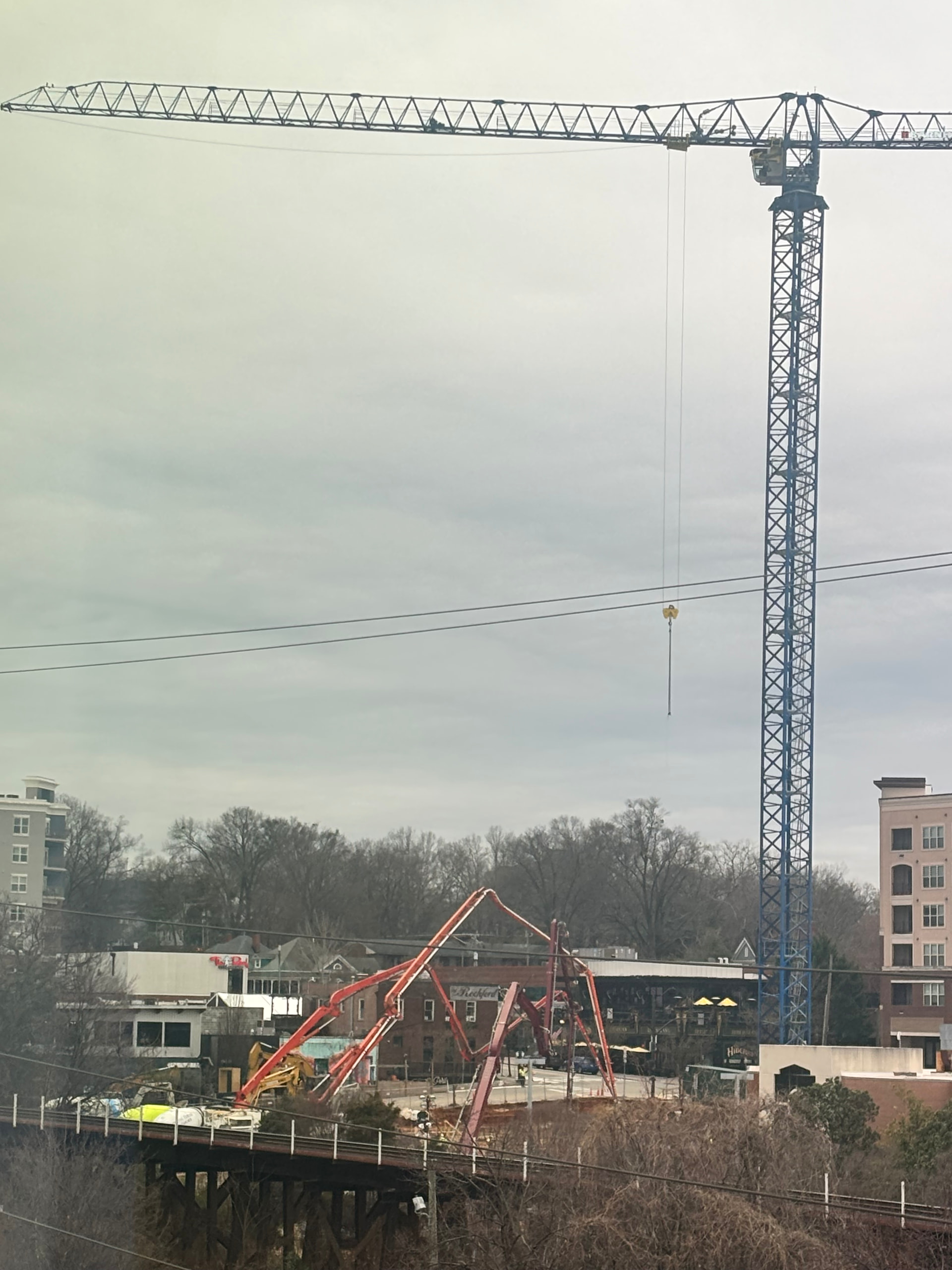

Is the concrete they are currently pouring really going to set up before several days worth of sub freezing temps? I think not. Iām not an engineer, but I do work with a lot of them. I just wonder what this does to the long term stability of the concrete if it isnāt allowed proper time to cure before extreme (freezing) temps. This has to be a partial reason for not doing road work up north during the winterā¦
Iāve had the same thoughts about the NC Education building as well. (I canāt tell if they were doing a pour on the mid-section along Jones Street today or not)
AI has thoughts on how the cold affects the curing.
Impact of Freezing Weather
-
Delayed Curing: If temperatures drop below 40āF (4āC), the curing process slows significantly, often taking twice as long to reach required strengths.
-
Reduced Strength: If concrete freezes within the first 24-48 hours, the internal water expands, destroying the internal bond between cement and aggregates. This can lead to a 50% reduction in strength, causing brittleness, cracking, and scaling.
-
Damage Potential: Concrete must reach a compressive strength of at least 500 psi (roughly 24-48 hours of proper curing) to withstand a single freeze-thaw cycle without permanent damage.
Best Practices for Cold Weather Pours
-
Maintain Temperature: Keep the concrete temperature above 50āF (10āC) for the first 3 to 7 days, if possible.
-
Use Protection: Utilize insulated blankets, tarps, or heated enclosures to trap heat and prevent the concrete from dropping below freezing for at least the first 48 hours.
-
Avoid Salt: Do not use deicing chemicals in the first few weeks, as they can cause scaling.
-
Monitor Conditions: Ensure the ground is not frozen when pouring, and consider using accelerated mix designs (Type III cement).
Itās 2026 and weāve built a few structures in our days (humans that is), so I suspect thereās one of those spinny cards with little holes that line up with the amount of concrete being poured, the temperature, the angle of the sun, if any shadow buildings are nearby and tells you magically how long to wait before you move on to the next phase of construction.
Just my guess but I do computer things.
You live in a tropical paradise. What do you know of such hardships???
Depends on the circumstances as to whether cold weather concrete placement is feasible.
There are best practices in the industry that involve use of additives that can protect against water freezing and/or accelerate the curing process.
Especially if going in the ground then the surrounding earth is usually well above freezing and may be in the mid-50ās at depth. Any surfaces exposed to surface air can be insulated and even surrounded with heated enclosures.
I think if I were building such a building, I might wait to pour. Just to be on the safe side. It is damn cold. And even referring to āUse Protectionā under Best Practices doesnāt get you āMaintain Temperatureā above 50 degrees for the first 3-7 days.
And @Oak City Dylan yeah no cred for you, my man. Living your best life with the cyber security nerds in the tropics. Go surfing or something.
I am just taking a guess that the engineers, architects, & contractors who are building this structure know what they are doingā¦ā¦
